|
         JWA (John Wayne Airport): One of Those Defining
        Moments
         January 20, 2009

        CALIFORNIA — John Wayne Airport (JWA),
        a prominent, Los Angeles regional facility which is tightly surrounded
        by high density commercial and residential areas and perched at the edge

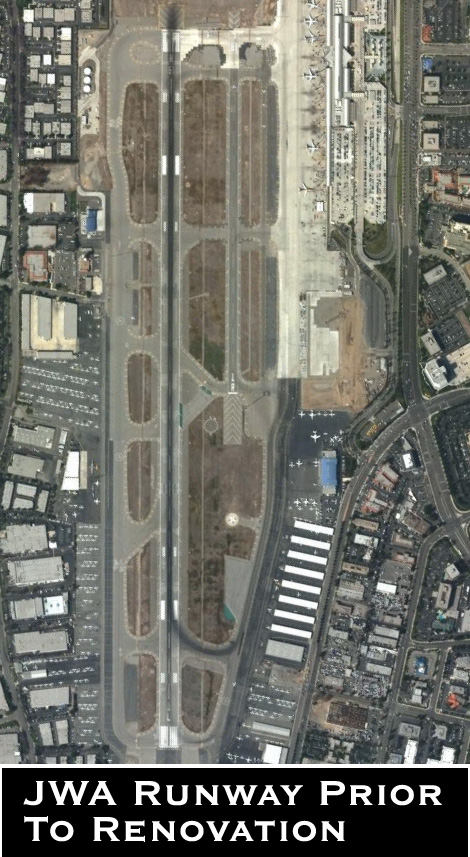

        of the Pacific Ocean, recently completed reconstruction of its primary
        runway. Kimley Horn & Associates, Inc. provided project administration
        and engineering while Butier Engineering, Inc. provided construction
        management. The contractor, All American Asphalt, Inc., provided
        construction supervision, materials, labor and equipment for the
        building of the project
        Primary work
        included coring the top three inches of aged pavement on the 5,700 foot
        main runway then re-paving the area with a PG 76-10 overlay.
        Included in the specification was the requirement for protecting 68,000
        square yards of runway shoulder and aprons with a protective coating
        which was:



             1. Waterborne

        2. Environmentally clean (no VOC's, no HAP's, no toxins or

        carcinogens and no PAH's)
             3. Fuel resistant
             4. 'Skid neutral'
        or better
             5. Insoluble to
        rain within 1 hour of curing
             6. Able to cure at
        night @ 50°F in less than six hours


           Those requirements set standards
          that only new innovation could

           solve, no product currently
          existed that would meet these

           guidelines.
          Due to its
          neighborhood proximity the Airport is regularly closed between the
          hours of 11:00 p.m. and 6:00 a.m. This presented the challenge of
          developing and installing a coating that could be placed and would
          achieve full cure within this time window so heavy jet traffic could,
          uninterrupted, perform all normal activities.  Since the contract
          penalty for interrupting normal JWA activities was $10,000 per
          minute, the decision process for selecting a coating which met all
          the requirements, especially those of the curing window was, to say
          the least, characterized by heightened drama.
          Ramsey Oil,
          Inc. a division of All American Asphalt, Inc. would install the
          coating.  Paul Snow, Ramsey’s crew manager, was tasked with
          coordinating night time field test applications of coating
          alternatives; which were then evaluated by JWA representatives.  After
          considering many options provided through the All American management
          team the head of procurement, John Todorovich, concurred with the JWA
          representatives that the product supplied by Ecostar Science &
          Technology, Inc. (a Lockheed Martin, Corp. spin-off) was the best
          choice.  That product was Carbon Plex H-25; manufactured under an
          Ecostar license by Delta Trading, Inc. of Bakersfield, CA.
          The
          installation of the coating was scheduled for late December 2008 but
          40°
          F night time temperatures left little margin for error, i.e. the
          Carbon Plex emulsion, which has exhibited the quality of fully curing
          down to that temperature, had only been tested at John Wayne at night
          time with 50°F
          temperatures.  The job was pushed to after the holidays with a “GO”
          set for the evenings of January 8th and 9th.
          Everyone was ‘antsy’ to wrap up this project after the months of
          coating study; even if it meant going in the middle of the winter, at
          night.  The weather report for those dates was for rising temperatures
          and clear skies, with possible ‘Santa Anna’ winds which would provide
          excellent drying conditions.  Everyone felt comfortable with pulling
          off this last critical phase of the Project.
        Seven thousand gallons of the
        “Cold Cure” version of the Carbon Plex H-25 was prepared, then diluted
        25% and shipped to the job site; ready to use.  A light tower rigged,
        2,000 gallon Bearcat distributor truck was readied, together with three
        mobile light tower platforms.  Against the back drop of jet engine roar
        the Ramsey Oil crew put on their ‘game face’ and huddled in the staging
        area at the pre-installation tailgate meeting with four JWA engineers
        and two inspectors.  Air and pavement temperatures were in the low 50's
        F.  The table was set for finishing the project except for one ‘fly in
        the ointment’ - FOG.  Wet fog was peppering the faces of all the men;
        and there was not a flutter of a breeze to move it.  The big question
        was, “Should we scrub the mission or push on?”  Paul Snow, who had the
        most experience with the Carbon Plex felt a cautious start was possible;
        paying close attention to the ‘break’ time.  The plan was to install a
        short run of the H-25, time the cure and then decide whether to ‘step on
        the gas’ or scrub the effort for the night.  Tension was high with
        everyone’s blood pressure ramping up.  The JWA engineers and inspectors
        then present, huddled to consider the cautious start proposal, then
        concurred with the All American crew manager; but their trepidation
        could be summed up with one unnamed individual stating that “If this
        application goes sideways you are going to see me hanging from the top
        of that (nearby) 100 foot eucalyptus tree.”
         At 10:45 p.m.
        the gates were opened and the convoy of trucks was escorted out through
        the fog hovering over the main runway.

         As
        the Carbon Plex H-25 does not need to be heated to cure under night time
        conditions, minimal heat (110°

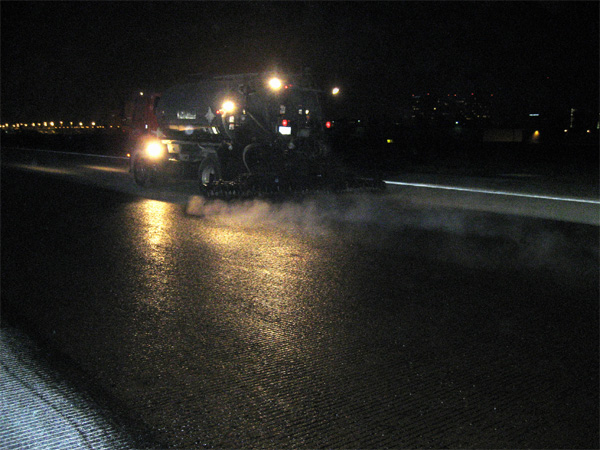

        F) was used to encourage drying.  At 11:07 p.m. the first twelve foot
        swath began at 0.10-0.12 gal/sq yd spread rate.  When the Bearcat
        operator ‘dropped the hammer’ and disappeared into the fog on its first
        mile plus run every eye at the start line leaned forward under the glare
        of the light tower to glean information from the flow pattern and color
        change of the freshly placed coating.
        The entire span
        of runway pavement surface had been saw cut with three eights inch deep
        grooves at one inch on center.  A special characteristic of the Carbon
        Plex H-25 is its rapid 10:1 (static/shear thin) viscosity rise after
        being pumped and sprayed.  In less than one second from hitting the
        pavement the static viscosity is nearly restored; assuring a significant
        resistance to puddling in the grooves.  On this foggy night it was
        performing as designed, with virtually no uneven film thickness between
        the pavement surface and the groove bottoms.
         At this point
        other good things began to happen. Before the Bearcat returned painting
        its second twelve foot swath, a black hue began to show in the over
        spray zone.  The Carbon Plex emulsion was breaking!!  Even with the
        atmospheric vapor content above the surface being at or near saturation
        the exothermic reaction designed into the “Cold Cure” version of H-25
        was kicking in and forcing the micronized emulsion water component to
        volatize.  By the time the distributor truck returned a collective
        “whew” had begun to set in.  The blood pressures of about two dozen hard
        working men were rapidly falling.  Mental resignation letters were being
        shredded. The JWA engineers granted that the installation could proceed.

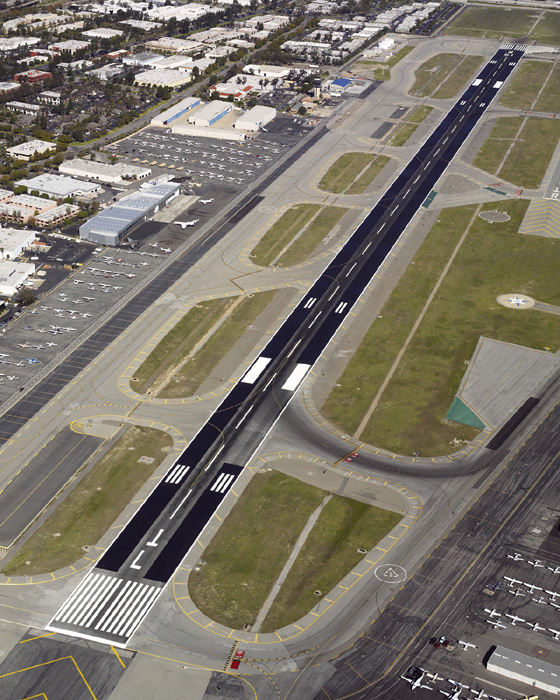

        By 1:45 a.m. the entire 640,000 s.f. was coated and curing at a
        predictable pace.  At about 3:30 a.m. the entire job was drivable; even
        though the fog had actually worsened at times.  No champagne was opened
        but everyone associated with the effort felt as though it may have been
        appropriate; as the first
        critical stage of the job had been accomplished.


        There are three
        distinct stages to the life cycle of this type of pavement
        preservation.
         Stage
        One had achieved complete
        success.  The coating was installed and cured in the allotted time and
        under the conditions prescribed.  Curing had progressed to a film
        sufficiently tough to resist tire displacement as well as becoming water
        fast with no chance of re-emulsification.
         Stage
        Two came the next morning
        when all the ‘normal’ people who have jobs which allow them to stay at
        home at night, could come out and witness the heavy jets trafficking
        over the fresh, shiny black coating.  Most importantly, like some clean
        room entry mat, the jets then would roll over the three foot wide, white
        thermoplastic stripe defining the runway, without one hint of any
        tracking!!  “Yeah team” could be read on the face of each early morning
        inspector as they knew ‘they’ had made the right decision(s). The
        performance was analogous to the test sites which, incidentally, were
        done without the benefit of fog.
         Stage
        Three will be to watch the
        product perform over the coming months and years; to see how well it
        endures under the insult of hot jet exhaust, unspent J5 vapor, salty fog
        and a hot Southern California solar bake.
         While the
        immediate reward is “No Penalties” there is also an intangible
        yield to this type of project.  That yield is the feeling of deep
        satisfaction within every professional associated with this effort; of
        thoughtfully and vigorously pushing the envelope and succeeding to
        achieve against unusual challenges.  We are also relieved to report that
        the next morning’s sun brightly shone on the 100 foot tall eucalyptus
        revealing no more weight in its branches than it bore the previous day!


        William Coe

        President, Ecostar Science and
        Technology, Inc.


        One of Those Defining Moments
